What is a Sprint Burndown Chart?

·303 words·2 mins
Aditi Agarwal
Author
Aditi Agarwal
Aditi Agarwal is a seasoned leader with 25+ years of experience driving enterprise transformation through product, data, and change management. Known for her empathetic leadership, she has led large-scale initiatives and scaled Agile practices to accelerate business value. Aditi integrates mindfulness and presence into leadership, helping professionals build presence, resilience, and well-being while delivering meaningful outcomes.
\[siteorigin\_widget class="SiteOrigin\_Widget\_Headline\_Widget"\]\[/siteorigin\_widget\]

The Sprint Burndown or the Iteration Burndown chart is a powerful tool to communicate daily progress to the stakeholders. It tracks the completion of work for a given sprint or an iteration. The horizontal axis represents the days within a Sprint. The vertical axis represents the hours remaining to complete the committed work. The purpose of a sprint burndown chart is to show the total amount of work remaining.

Let’s take an example. The below table shows the actual number of hours remaining at the end of each day within a Sprint to create a sample Sprint burndown chart. The table also captures data for ideal remaining hours. The ideal remaining effort is calculated by assuming a uniform rate of task completion each day. In the below example, you can see that the ideal and actual remaining hours were same at the beginning of the sprint, however, as the sprint progresses, the actual remaining hours vary from the ideal remaining hours.

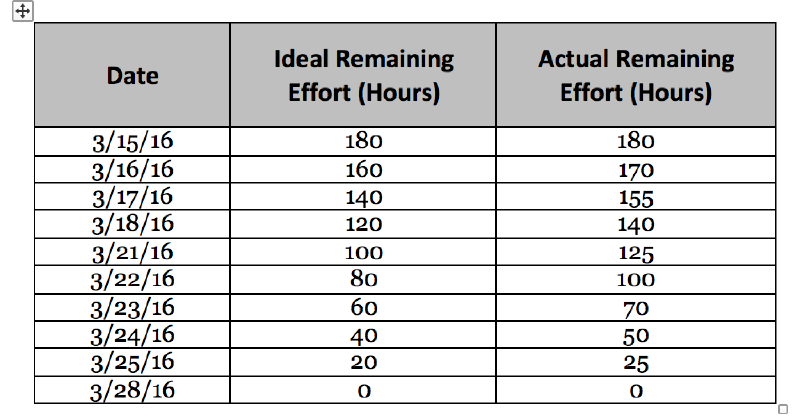

Sprint Burndown Chart Table

Next, we will plot a sample Sprint Burndown chart using the above table data. The below diagram depicts the sample chart with ‘Date’ represented on the horizontal axis and ‘Remaining Effort (Hours)’ represented on the vertical axis.

Sample Sprint Burndown Chart

From the above chart, you can conclude that:

  • There were no spillover stories since the actual remaining hours at the end of the sprint were zero.
  • The team started a bit slow in the first week of the sprint, but then caught-up during the second week.
